Project Workflow
Project
Workflow.
A structured overview of documented site activities, work progress and service stages based on the latest shared project reports, giving visitors a clearer view of how Sai Megah coordinates, monitors and completes each workflow on site.
Daily Progress
Site activity flow based on shared reports.
Work Stages
Process sequence for different service scopes.
Site Records
Documented project details for clearer reference.
Sai Megah Group
Project Workflow Overview.
A structured view of documented work stages, site activities and estimated durations based on the latest shared project reports, presented for clearer project reference and service understanding.

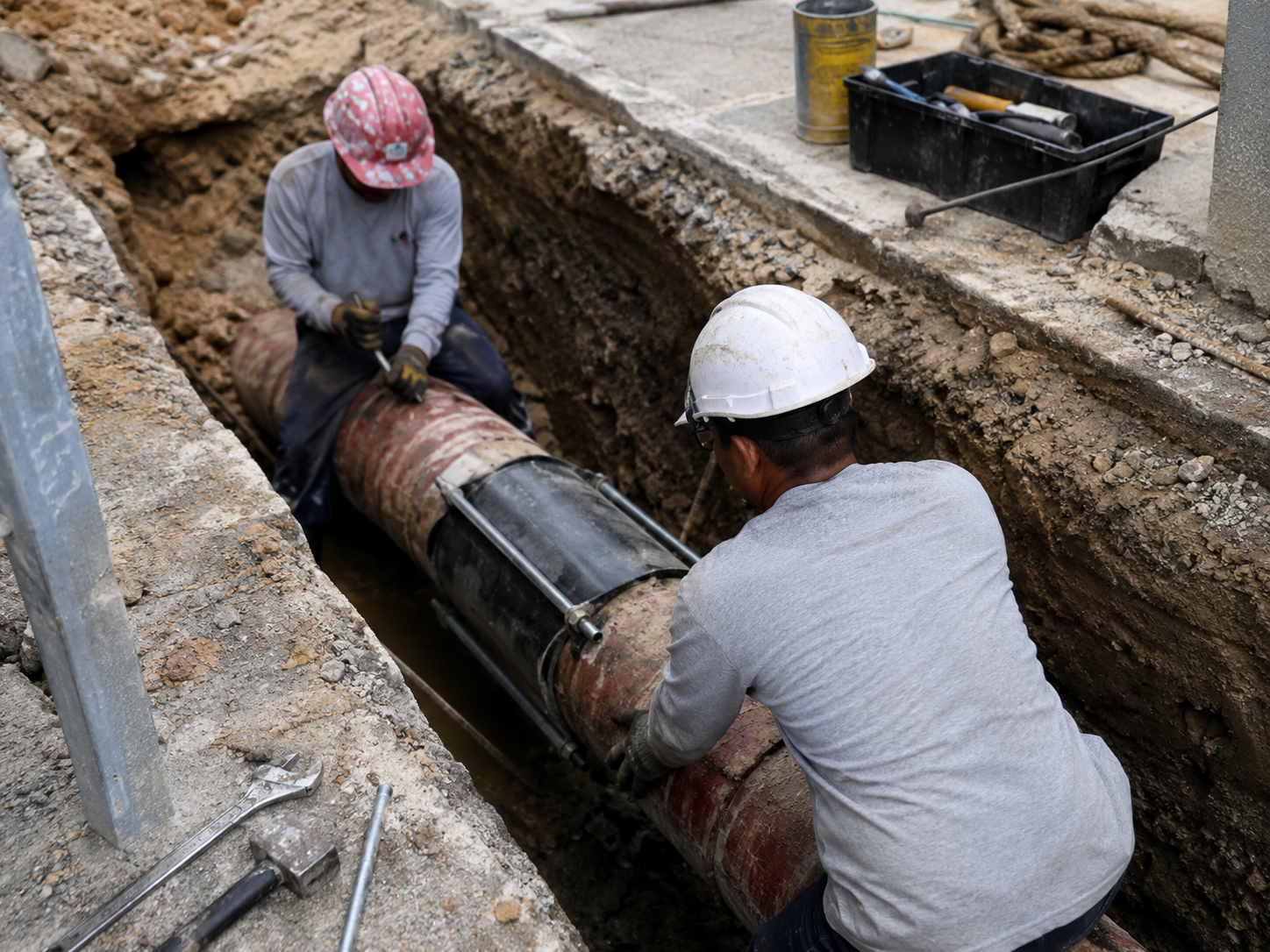

Bomba Pipe Repair Works
●Casa Indah
Workflow Summary
- Leakage observed at the drain area.
- Excavation carried out to expose the affected underground pipe section.
- Damaged pipe segment identified and prepared.
- Welding repair carried out on the pipe section.
- Leakage test conducted after repair.
- Backfilling, final cleaning and excess sand disposal completed.

Painting & Repair Works
●Internal Painting Works
Workflow Summary
- Corridor painting started.
- Balcony painting carried out at selected units.
- Corridor painting and repair works continued.
- Finishing layers completed at corridor and staircase areas.
- Lobby and balcony touch-up works continued.
- Parking works covered ceiling, crack repair, undercoating, finishing layers and door/front paint works.

Swimming Pool Tile Repair Works
●Widuri — Main Pool & Wading Pool
Workflow Summary
- Tile repair works commenced.
- Daily repair activities were documented from Day 1 onward.
- Main pool and wading pool repair activities progressed.
- Intermediate daily works were largely photo-documented.
- Cleaning and progress checks continued through the repair period.
- Finishing works were recorded on Day 15.

Rooftop Membrane Waterproofing & Repair Works
●Roof Areas D-36-06 & D-38-06
Workflow Summary
- Work began by hacking old concrete roof areas.
- Surface preparation and repair works were carried out.
- Waterproof membrane and protective layer with canvas were applied.
- Roofing membrane waterproofing and repair progressed across the reported days.
- Daily progress was documented through Day 17.
- Intermediate daily entries were largely photo-documented.

External Window Cleaning Works
●My Maison
Workflow Summary
- Anti-vibration barriers, caution tape and warning signs were set up.
- Site inspection and safety checks were completed before work started.
- Equipment was prepared and access / working position identified.
- External cleaning was carried out with proper equipment.
- Safety measures and public protection were maintained.
- Windows were inspected, cleaned and safety barriers removed after work.

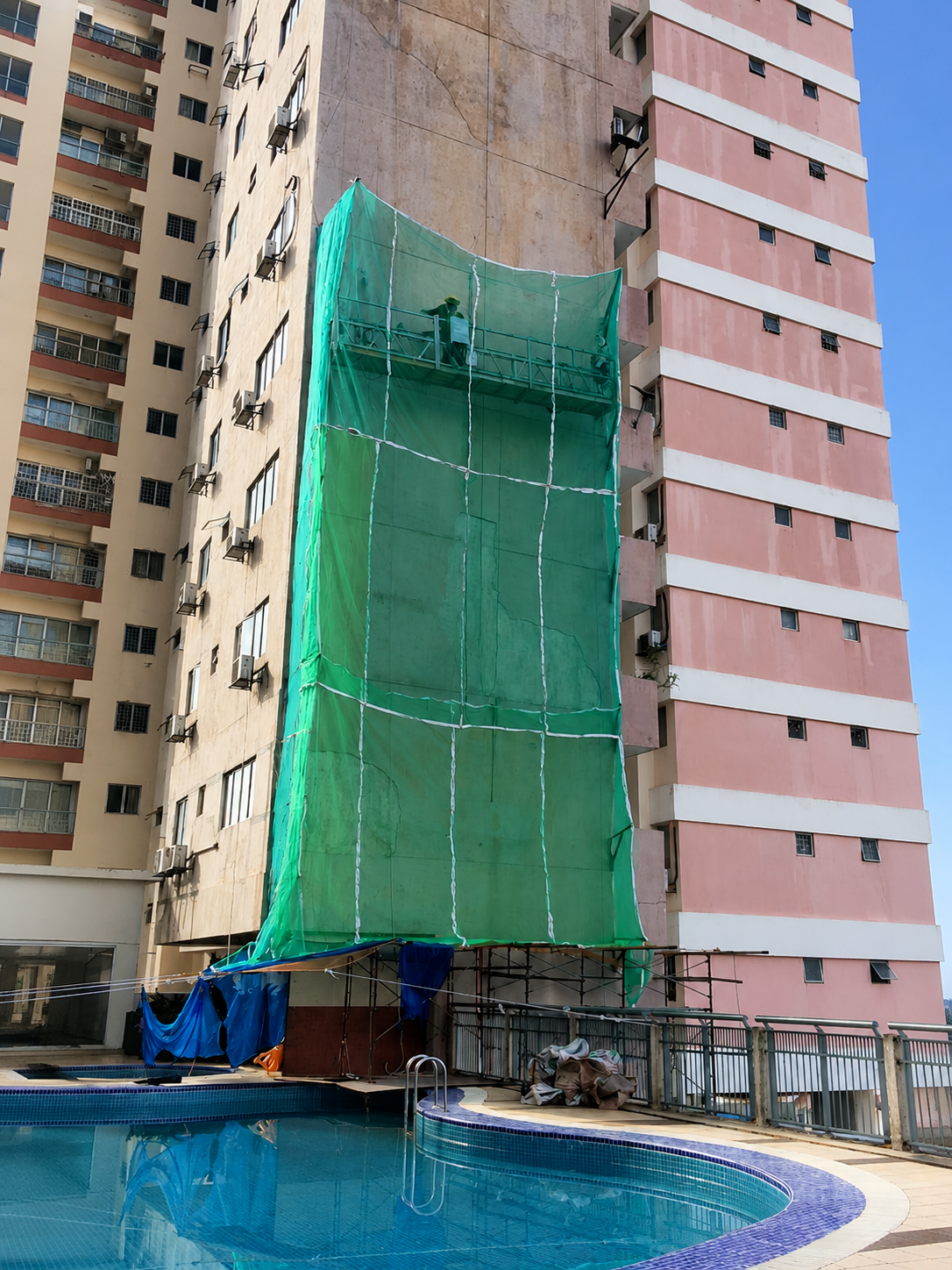

Structural Wall Repair Works
●Beverly Tower
Workflow Summary
- Site arrival, inspection and material unloading were carried out.
- Scaffolding, safety netting and access platform were prepared.
- Installation and welding works for gondola preparation were performed.
- Lift covering, gondola installation, engine cable work and repositioning were recorded.
- JKR visit and gondola inspection were documented.
- Hacking work continued with monitoring, debris control, roof disposal, pool protection and daily clean-up.
Estimated durations are based on documented report dates, recorded work-day spans and common industry project duration ranges. Actual duration may vary depending on site condition, access, weather, repair complexity and work scope.
